From Solar Manufacturer to Solar Exporter: What India Must Fix Before Competing Globally

From Solar Manufacturer to Solar Exporter: What India Must Fix Before Competing Globally

Building enough manufacturing capacity to serve your own country’s demand and building the credibility to sell into someone else’s are different problems, even when the factory is identical. Domestic demand in India has been substantially shaped by policy — ALMM listing, DCR mandates, PM Surya Ghar, PLI incentives — all of which create guaranteed or heavily incentivised buyers. Export markets offer none of that protection. A buyer in Germany, the US, or the Middle East evaluates an Indian module against Chinese, Southeast Asian and increasingly other alternative suppliers on cost, quality documentation and delivery reliability alone.

India’s module manufacturing capacity has grown enormously — from under 10 GW in 2018 to roughly 172 GW by 2026, a seventeen-fold expansion. But capacity built primarily for a protected domestic market does not automatically translate into export competitiveness, and the gap between the two is where the real work now sits.

Domestic Scale vs Export Credibility: Why They’re Different Problems

A manufacturer selling into India’s DCR-mandated or ALMM-listed segments benefits from policy-created demand that doesn’t require winning against unrestricted global competition on price and documentation. Export buyers offer no such floor. They evaluate suppliers on: verifiable, consistent quality across large order volumes; internationally recognised bankability status (whether project lenders and insurers will underwrite projects using that manufacturer’s modules); logistics reliability; and landed cost after tariffs, shipping and financing costs — not ex-factory price alone.

Export Quality and Consistency: A Higher Bar Than Domestic Compliance

Domestic compliance in India centres on IEC and BIS certification and ALMM listing — real, meaningful standards, but ones that certify a design and sample, not the consistency of every subsequent production batch. Export buyers, particularly larger utility-scale developers and institutional buyers, typically demand much more granular batch-level quality documentation, because a defect discovered after a container has shipped internationally is far more expensive to remediate than one caught domestically. This is where the kind of systematic EL testing, binning and PID/LID characterisation described in Websol’s article on solar cell quality beyond efficiency stops being a nice-to-have and becomes table stakes for serious export ambitions.

Bankability: The Credibility Problem That Isn’t About the Product Itself

“Bankability” refers to whether project lenders, insurers and independent engineers will underwrite a solar project built with a given manufacturer’s modules — a status built over years through track record, financial stability, warranty performance history, and independent testing, not through a single certification. Chinese manufacturers with over a decade of large-scale international shipment history have deep bankability track records that newer Indian exporters, however technically capable, cannot replicate overnight. This is arguably the single hardest gap to close quickly, because it depends on accumulated field performance data that can only be built through time and shipped volume — not through capacity investment alone.

Cost Competitiveness: Narrowing, But Not Closed

The price gap between Indian and Chinese solar products has narrowed over recent years but has not closed. Reporting on the export landscape has noted Indian manufacturers offering increasingly competitive pricing, even as the absolute gap with Chinese suppliers persists. Separately, broader cost-structure research attributes India’s residual manufacturing cost disadvantage — roughly 9 percent higher module manufacturing cost than China — mainly to energy costs and labour productivity rather than capital cost differences, meaning the gap is structural rather than a simple pricing decision manufacturers can choose to close.

Trade Barriers: A Live and Shifting Landscape

Export competitiveness isn’t decided by cost and quality alone — trade policy in destination markets matters just as much, and it has been actively moving. On the US side, tariff changes have cut both ways for Indian exporters: reporting has noted a reduction of import duties on Indian solar products from 50% to 18%, creating a meaningful cost advantage relative to Chinese suppliers facing higher tariff rates in that market. At the same time, separate anti-dumping proceedings have moved in the other direction — analysis of the broader trade landscape has flagged a preliminary anti-dumping rate as high as 123% levied against Indian solar cells, with final determinations pending. These two developments illustrate why export strategy can’t be built around a single market’s current tariff snapshot — trade rulings shift, sometimes quickly, and diversification across markets is as much a risk-management strategy as a growth strategy.

European procurement policy adds another dimension: reporting on the export landscape notes that European Union member states have adopted frameworks that in some cases explicitly exclude Chinese products from tender processes or apply scoring advantages to non-Chinese suppliers — a policy shift that creates genuine market access opportunity for Indian exporters, provided the quality and bankability gap is closed enough to be competitive within that opening.

Global Buyer Expectations Beyond Price

International buyers, particularly in mature markets, increasingly expect supply-chain traceability and documented domestic content or origin verification as part of procurement due diligence — not just for compliance in India’s own DCR-mandated segments, but as a broader trust signal. The traceability infrastructure India has built domestically through the NISE DCR Verification Portal (covered in more detail in Websol’s article on DCR vs non-DCR solar cells) is, in principle, a transferable credibility asset for export buyers as well — a documented, serialised manufacturing history is valuable to any sophisticated buyer, not just a domestic scheme administrator.

Logistics and Landed Cost

Ex-factory price is not what an international buyer pays. Shipping cost, lead time, port access, and financing cost between order and delivery all factor into the landed cost comparison against alternative suppliers. Manufacturers based in regions with strong port access and established shipping lane relationships have a structural advantage here that is separate from, but compounds with, ex-factory cost competitiveness.

Potential Export Markets and Where India’s Opening Actually Sits

Diversification into markets like the Middle East and Africa has been identified as an important pathway, though one that faces real headwinds — Chinese suppliers currently hold a dominant share of price-sensitive markets in these regions. The more immediate opening appears to be in markets actively pursuing supply-chain diversification away from China for strategic reasons — the US (subject to the tariff and anti-dumping dynamics above) and parts of Europe — where Indian manufacturers’ relative cost competitiveness against China, though not fully closed, matters less than their ability to offer a credible non-Chinese alternative at all.

What India Must Fix, In Order of Difficulty

Gap

Difficulty to close

What closing it requires

Cost competitiveness vs China

Medium-hard (structural)

Energy cost reduction, labour productivity gains, scale efficiencies over years

Export-grade quality consistency

Medium

Systematic EL testing, binning discipline, batch documentation — achievable within existing operations

Bankability track record

Hard (time-dependent)

Years of shipped volume and field performance data; cannot be accelerated by investment alone

Trade barrier navigation

Not fully controllable

Market diversification, active monitoring of tariff and anti-dumping proceedings

Logistics and landed cost

Medium

Port access, shipping relationships, financing structure optimisation

Traceability and documentation credibility

Medium (infrastructure exists)

Extending domestic DCR-style traceability discipline to export-facing documentation

Why This Matters Beyond Any Single Manufacturer

India’s broader manufacturing self-reliance journey, covered in Websol’s article on India’s solar manufacturing journey from imports to self-reliance, has largely been framed around reducing import dependence for domestic demand. Becoming a credible exporter is the next, harder chapter of that same story — and one that depends on factors, like bankability and quality-system depth, that don’t respond as quickly to policy support as capacity expansion did. For manufacturers themselves, the practical starting point is evaluating supply-chain and quality partners with export credibility in mind from the outset, a consideration covered in Websol’s guide on choosing a solar cell supplier.

Key Takeaways

  • Domestic manufacturing scale, built substantially on policy-supported demand, does not automatically translate into export competitiveness.
  • Export buyers weight batch-level quality consistency, bankability track record and landed cost far more heavily than domestic scheme compliance requires.
  • India’s cost disadvantage against China (roughly 9%) is structural, tied to energy costs and labour productivity, not simply pricing strategy.
  • Trade barriers are volatile and market-specific — US tariff reductions and anti-dumping proceedings have moved in opposite directions simultaneously.
  • Bankability is the hardest gap to close because it depends on accumulated shipped volume and field performance history, not investment alone.

Frequently Asked Questions

Q: Is India currently a significant solar module exporter?

India’s export volumes have grown but remain well below the country’s manufacturing capacity, with market commentary suggesting current export share is still significantly lower than the potential capture available to Indian manufacturers given global demand for supply-chain diversification.

Bankability refers to whether project lenders and insurers will underwrite a solar project built using a specific manufacturer’s modules, based on accumulated track record and independent performance data — it is a trust asset built over years of shipped volume, not something achieved through a single certification or capacity announcement.

The picture is mixed: general import duty reductions have improved India’s relative position against China in the US market, while separate anti-dumping proceedings have introduced preliminary duties specifically targeting Indian solar cells, with final rulings still pending as of mid-2026.

The price gap has narrowed but not closed. Cost-structure research attributes India’s remaining roughly 9% cost disadvantage mainly to higher energy costs and lower labour productivity rather than capital investment differences.

Markets actively pursuing diversification away from Chinese suppliers for strategic reasons — including parts of the US and European Union — currently offer the more accessible opening, since buyers there are prioritising a credible non-Chinese alternative, whereas highly price-sensitive markets like parts of Africa remain dominated by low-cost Chinese suppliers.

In principle, yes — a documented, serialised manufacturing history built for domestic DCR compliance is a transferable trust asset that can support export-facing quality and origin documentation, even though it wasn’t originally designed with export buyers in mind.

What Makes a Solar Factory Globally Competitive? A Look at Cost, Automation, Skills and Process Innovation

What Makes a Solar Factory Globally Competitive? A Look at Cost, Automation, Skills and Process Innovation

“Competitive” gets used loosely in solar manufacturing discussions — sometimes meaning cheapest, sometimes meaning highest efficiency, sometimes meaning largest scale. None of those alone is a reliable predictor of whether a factory can actually win and retain business against global suppliers over a multi-year horizon. Competitiveness is closer to a portfolio of factors that reinforce or undermine each other, and a factory that is strong on one dimension but weak on several others tends to lose ground once market conditions shift.

This article sets out a practical framework — not a ranking of countries, but a structured way to evaluate what a solar manufacturer actually needs to compete globally, and where India’s current position sits against it.

Energy Cost: The Input That Compounds

Solar cell and wafer manufacturing is energy-intensive, particularly at the furnace and deposition steps. Energy cost differences between manufacturing hubs don’t just affect a single line item — they compound across every production step that involves heating, cooling or plasma processing, which is most of the cell manufacturing sequence. A factory operating in a region with higher industrial electricity tariffs starts every cost comparison at a structural disadvantage that automation and scale can offset but rarely fully erase.

Labour Productivity: Automation’s Real Value

Labour cost per worker is one thing; labour productivity — output per worker-hour — is the number that actually matters for cost per watt. This is where automation earns its return. Automated material handling, in-line testing and process control reduce the labour hours needed per unit of output while also reducing the yield losses associated with manual handling variability, a dynamic explained in Websol’s article on how automation is reducing solar production costs. Research comparing Indian and Chinese solar manufacturing costs has specifically identified lower labour productivity, alongside higher energy costs, as a driver of India’s roughly 9% cost disadvantage in module manufacturing relative to China — underscoring that this is not primarily a wage-rate issue but a productivity-per-worker issue that automation and process maturity are best positioned to close.

Yield and Equipment Utilisation: Converting Capacity Into Cost Advantage

A factory’s real unit cost depends on how much of its processed material becomes sellable, in-specification product, and how much of its available production time is actually used. These two factors — yield and utilisation — determine whether announced capacity translates into competitive cost per watt, a relationship explored in more depth in Websol’s article on how solar cells are manufactured. A factory with excellent equipment but mediocre process discipline will lose a cost competition to a factory with more modest equipment but tighter yield control.

Raw Material Cost and Supply-Chain Localisation

Polysilicon, wafers, and silver paste are the dominant material costs in cell manufacturing, and a factory’s exposure to global price volatility in these inputs — particularly silver, which has seen sustained price pressure — is a direct competitiveness factor. Manufacturers actively reducing silver consumption per cell through finer busbar designs and paste optimisation, as described in Websol’s article on why silver matters in solar cell manufacturing, are directly improving their cost competitiveness independent of scale or automation. Supply-chain localisation — sourcing critical inputs domestically rather than through import-dependent chains — reduces both cost volatility and lead-time risk, which matters as much for reliability of delivery as for headline cost.

Technology and Process Innovation

Competitiveness is not static. A factory that adopted the most cost-effective technology available five years ago (Mono PERC) can find itself at a disadvantage today against factories that have moved to TOPCon or HJT, which offer better efficiency and lower degradation. India’s own manufacturing base illustrates the scale of this shift: roughly 70% of installed module capacity is now TOPCon-based. But technology adoption alone isn’t the whole story — process innovation within a given technology (tighter process windows, better in-line testing, incremental efficiency gains) is what separates factories running the same nominal technology at meaningfully different cost and quality levels.

Quality Systems: The Competitiveness Factor That’s Easy to Underrate

A factory can be cost-competitive on paper and still lose international business if its batch-to-batch consistency and defect detection systems aren’t robust enough to satisfy global buyers, who typically demand tighter quality documentation than domestic buyers. This is where systematic EL testing, binning discipline and PID/LID characterisation — covered in Websol’s article on solar cell quality beyond efficiency — function as a competitiveness factor in their own right, not just a compliance requirement. Export buyers in particular tend to weight quality-system maturity heavily in supplier selection, because the cost of a field failure discovered after shipment is far higher than the cost of catching it in-line.

Workforce Skills: The Compounding Asset

Automation reduces the need for manual labour in routine tasks, but it increases the value of skilled process engineers who can interpret automated system data, diagnose drift, and continuously refine process parameters. A workforce with deep, accumulated experience on a specific production line catches problems earlier and resolves them faster than a newly assembled team — this is one of the reasons rapid technology transitions carry a real productivity cost during the retraining period, and why workforce continuity is itself a competitiveness asset that doesn’t show up in capacity or cost figures.

Scale: Necessary, Not Sufficient

Scale matters because it allows fixed costs — R&D, quality infrastructure, senior process engineering talent — to be spread across more output, improving unit economics. But scale without yield discipline, quality systems and process innovation simply produces more output at the same (or worse) cost structure, not a genuinely more competitive one. This is why capacity figures alone are a poor proxy for competitiveness, a point developed further in Websol’s article on the future of solar manufacturing in India.

Financing Cost and Access

Cell and module manufacturing is capital-intensive, and the cost of capital directly affects how quickly a manufacturer can invest in the automation, quality systems and technology upgrades needed to stay competitive. Manufacturers with access to lower-cost financing — whether through government-backed schemes, export credit, or stronger balance sheets — can invest through market downturns in ways that thinly-capitalised competitors cannot, which compounds into a durable competitiveness gap over time.

Export Logistics

For manufacturers targeting international markets specifically, logistics cost and lead time to key ports and shipping routes are a real, if less discussed, competitiveness factor. A factory with excellent unit economics but poor logistics access to major export markets faces a landed-cost disadvantage that domestic-market competitiveness metrics don’t capture.

Bringing the Framework Together

Factor

What it determines

Where it’s easy to underrate

Energy cost

Baseline cost structure

Compounds across most process steps

Labour productivity

Real cost per watt, not wage rate

Automation’s actual return depends on this, not headcount reduction alone

Yield & utilisation

Whether capacity becomes real, sellable output

Rarely disclosed publicly, unlike capacity figures

Material cost & localisation

Exposure to input price volatility

Silver cost specifically, given recent price trends

Technology & process innovation

Whether the process itself improves over time

Easy to conflate with simply adopting newer equipment

Quality systems

Ability to win and retain export business

Often treated as compliance rather than competitiveness

Workforce skill

Speed of problem diagnosis and resolution

Doesn’t show up in any capacity or cost announcement

Scale

Fixed-cost absorption

Only useful when paired with yield and quality discipline

Financing access

Ability to invest through cycles

Determines who can sustain R&D and automation investment

Export logistics

Landed cost in target markets

Separate from domestic manufacturing competitiveness entirely

Where This Leaves Indian Manufacturers

India has made genuine progress on several of these dimensions — most visibly technology adoption (the TOPCon shift), policy-supported scale, and growing quality-system maturity, an area explored across Websol’s guides on Indian solar cell manufacturers and supplier evaluation. The more persistent gaps — energy cost, labour productivity, and full upstream supply-chain localisation for polysilicon and wafers — are structural and will take longer to close than capacity expansion has taken.

Key Takeaways

  • Global competitiveness in solar manufacturing depends on a portfolio of factors, not any single metric like cost, capacity or efficiency alone.
  • Energy cost and labour productivity are the two structural factors most often cited in India-China cost comparisons.
  • Yield, utilisation and quality-system maturity convert raw capacity and technology adoption into actual competitive advantage.
  • Workforce skill and financing access are less visible but genuinely compounding competitiveness assets.
  • Scale is necessary but not sufficient — it only improves competitiveness when paired with process discipline.

Frequently Asked Questions

Q: What is the single biggest factor in solar manufacturing competitiveness?

There isn’t one — competitiveness depends on a combination of cost structure, process discipline (yield and quality), and continuous technology and process innovation. Manufacturers that lead on one dimension but lag significantly on others typically lose ground over time.

Research comparing manufacturing costs has found Indian module production is roughly 9% more expensive than Chinese production, driven mainly by higher energy costs and lower labour productivity, even where investment costs are comparable.

No. Automation improves labour productivity and yield consistency, but competitiveness also depends on material costs, technology choice, quality systems, workforce skill and access to financing — automation addresses only some of these factors.

Scale helps by spreading fixed costs like R&D and quality infrastructure across more output, but scale without yield discipline and quality systems simply produces more output at an unchanged or worse cost structure.

Export buyers typically weight supplier quality-system maturity heavily in their selection process, because catching defects in-line is far cheaper than field failures discovered after shipment — making quality systems a direct commercial advantage, not just a certification requirement.

Yes, in the near term, but exposure to imported polysilicon, wafers and equipment carries currency, tariff and lead-time risk that fully localised competitors don’t face, which is why supply-chain localisation is increasingly treated as a medium-term competitiveness priority rather than optional.

Solar Manufacturing Beyond Capacity: Why Yield, Utilisation and R&D Will Decide India’s Next Phase

Solar Manufacturing Beyond Capacity: Why Yield, Utilisation and R&D Will Decide India's Next Phase

India’s solar manufacturing story is usually told through one number: gigawatts of capacity. It’s an easy number to announce, an easy number to compare year over year, and an easy number to use as evidence of industrial progress. It is also, on its own, a poor predictor of whether a manufacturing sector is actually competitive.

Capacity tells you what a set of factories could theoretically produce if everything ran perfectly. It says nothing about how much of that capacity is actually operating, how efficiently, at what yield, or whether the underlying process technology is keeping pace with global cost curves. India’s own manufacturing data illustrates this gap clearly — and the gap matters more, not less, as the sector matures.

The Capacity Number India Usually Leads With

By the end of 2025, India’s cumulative solar module manufacturing capacity had reached approximately 210 GW, according to Mercom India’s State of Solar PV Manufacturing in India 2026 report, with module capacity under the government’s Approved List of Models and Manufacturers (ALMM) List-I standing at around 173 GW. On paper, this looks like a manufacturing sector that has scaled dramatically — and in terms of module assembly capacity, it genuinely has.

But the same report puts India’s cell manufacturing capacity at only around 27 GW, with ALMM List-II cell capacity at roughly 26.5 GW — meaning that even at full utilisation, the vast majority of India’s announced module capacity would need to run on imported cells, primarily from China, to actually produce modules. Research from the Council on Energy, Environment and Water (CEEW) frames this starkly: nameplate solar cell manufacturing capacity forms only around 20 per cent of India’s module manufacturing capacity, meaning roughly 80 per cent of module output would need to depend on imported cells.

This single comparison — 210 GW of module capacity against 27 GW of cell capacity — is the clearest illustration available that “capacity” as a headline number obscures more than it reveals about actual manufacturing depth.

Nameplate Capacity Is Not Utilisation

Even within the segments where India does have strong capacity, announced GW figures say nothing about how much of that capacity is actually running. A factory can be capacity-rated at 5 GW/year and running at 60% utilisation because of order-book gaps, working-capital constraints, input shortages, or unplanned downtime — producing an effective 3 GW/year of actual output. Utilisation depends on demand visibility, financing costs, and operational discipline, none of which are captured by a capacity announcement.

The Indian solar cell supply situation adds a second layer to this: even where cell capacity does exist, much of it has faced tight availability relative to demand, a dynamic covered in more detail in Websol’s article on India’s solar cell supply crunch. A capacity figure that looks adequate on paper can still translate into a procurement risk in practice if utilisation, yield or input availability don’t line up with it.

Yield: The Number That Turns Capacity Into Real Output

Nameplate capacity assumes every wafer that enters a line comes out as a sellable cell. In reality, no line achieves that. The share of processed material that becomes sellable, in-specification product — yield — is what actually converts theoretical capacity into real, monetisable output. Two factories with identical announced capacity can have very different real output and cost structures depending on their yield discipline, a dynamic explored in depth in Websol’s article on how solar cells are manufactured step by step, which lays out where losses accumulate through the production sequence.

This is why capacity announcements should be read as an upper bound, not a forecast. India’s cell manufacturing base includes lines at very different points on their yield-maturity curve — some running mature, well-optimised processes, others still in the ramp-up period that follows a new commissioning, which industry reporting suggests can take 18 to 24 months to reach stable yields. Aggregate national capacity figures blend all of these together into a single number that flatters the newest, least-proven additions as much as the most mature ones.

Cost Per Watt: Where Utilisation and Yield Actually Show Up

The commercial consequence of low utilisation and low yield is straightforward: higher cost per watt, for a given level of capital investment. This matters directly for India’s competitive position, since research comparing Indian and Chinese solar manufacturing costs has found that higher operating costs — driven by energy costs and lower labour productivity — make solar module manufacturing in India roughly 9 percent more costly than in China, even where investment costs are broadly comparable. Utilisation and yield gaps compound that structural cost disadvantage rather than offsetting it. For project developers, this cost dynamic ultimately flows into the levelised cost of electricity calculations covered in Websol’s guide to LCOE.

Solar Factory Growth and Innovation | Websol Energy System Ltd

R&D: The Variable Capacity Numbers Don’t Capture at All

Perhaps the least visible gap in India’s manufacturing capacity story is R&D depth — investment in process improvement, next-generation cell architectures, and the kind of incremental efficiency gains that separate a mature manufacturing base from one that is simply assembling licensed or imported process technology at scale.

Capacity growth driven primarily by adding more lines of an existing, externally sourced process is a different achievement than capacity growth driven by improving the process itself. India’s rapid capacity expansion has been real and substantial, but the sector’s long-term competitiveness depends on whether that expansion is paired with genuine investment in process R&D, automation, and next-generation technology readiness — not just on replicating existing lines at larger scale. This is one of the more consequential open questions in India’s future of solar manufacturing, and it connects directly to the country’s broader ambitions to move from cell manufacturer to global exporter.

Automation and Workforce Skills: The Operational Layer Beneath R&D

Between raw capacity and long-term R&D sits a more immediate lever: how well existing lines are operated. Automation — in material handling, in-line testing, and process control — directly improves both yield and utilisation by reducing variability and unplanned downtime, a dynamic explained in Websol’s piece on how automation is reducing solar production costs. Workforce skill depth compounds this: an experienced operations team catches process drift earlier and troubleshoots faster than a newly trained one, which matters disproportionately during the ramp-up periods that accompany rapid capacity expansion.

Supply-Chain Resilience: Capacity’s Silent Dependency

Even a factory running at excellent yield and utilisation is only as resilient as its input supply chain — polysilicon, wafers, silver paste, and specialised equipment, much of which India still imports. The government scheme support built around domestic manufacturing, covered in Websol’s article on solar cell manufacturing government schemes and supply chain, is explicitly designed to close this dependency over time — but supply-chain depth, like R&D depth, doesn’t show up in a capacity announcement at all.

A Better Framework for Assessing Manufacturing Strength

Metric

What headline capacity misses

Utilisation

How much of the announced capacity is actually running

Yield

How much of what’s processed becomes sellable output

Cost per watt

Whether that output is produced competitively

R&D depth

Whether the process itself is improving, not just scaling

Supply-chain resilience

Whether upstream inputs can support sustained output at scale

Workforce and automation maturity

Whether operational discipline supports consistent quality over time

None of these replace capacity as a useful number — a country or company genuinely does need physical capacity to compete. But capacity is a necessary condition for manufacturing strength, not a sufficient one, and treating it as the primary scorecard risks mistaking scale for competitiveness.

Key Takeaways

  • India’s ~210 GW of module capacity sits against only ~27 GW of cell capacity, illustrating how capacity figures can mask structural gaps.
  • Utilisation (how much capacity actually runs) and yield (how much of what runs becomes sellable product) both convert theoretical capacity into real output.
  • Indian module manufacturing costs run roughly 9% above China’s on a like-for-like basis, driven by energy costs and labour productivity, not investment cost.
  • R&D depth and supply-chain resilience are largely invisible in capacity announcements but matter as much for long-term competitiveness.
  • A more complete assessment of manufacturing strength requires utilisation, yield, cost, R&D and supply-chain metrics alongside capacity.

Frequently Asked Questions

Q: Why does India have so much more module capacity than cell capacity?

Cell manufacturing is far more capital- and process-intensive than module assembly and has historically required a longer ramp-up period, so it has scaled more slowly even with strong policy support. Module assembly, being comparatively low-capital and fast to bring online, expanded much faster in response to demand.`

Not automatically. Capacity announcements reflect investment decisions and construction milestones, not necessarily current output, yield maturity, or cost competitiveness, all of which take longer to establish than the physical capacity itself.

Research comparing the two markets has found Indian module manufacturing costs are roughly 9% higher than China’s, driven primarily by energy costs and lower labour productivity rather than differences in investment cost.

Utilisation data is less consistently and publicly reported than capacity figures, which is part of why capacity remains the dominant headline metric even though it is a less complete measure of actual manufacturing output.

R&D depth determines whether a manufacturer’s process improves over time — better yield, lower material consumption, higher efficiency — independent of how many production lines it operates. Over a multi-year horizon, this compounding process improvement can matter more for competitiveness than adding further nameplate capacity.

A combination of utilisation rates, yield data, cost per watt benchmarks against global peers, R&D investment intensity, and supply-chain self-sufficiency for key inputs like polysilicon, wafers and silver paste, alongside — not instead of — capacity figures.

What Happens When a Solar Cell Factory Changes Technology? The Hidden Cost of Production-Line Transition

Beyond the physical installation of new deposition equipment, industry reporting suggests new or converted TOPCon lines typically take 18 to 24 months after commissioning to reach stable, mature production yields, even though some output is possible well before that point.

Lorem ipsum dolor sit amet, consectetur adipiscing elit. Ut elit tellus, luctus nec ullamcorper mattis, pulvinar dapibus leo.

What Happens When a Solar Cell Factory Changes Technology? The Hidden Cost of Production-Line Transition

From the outside, a technology transition looks like a press release: a manufacturer announces it is converting a Mono PERC line to TOPCon, or adding HJT capacity. What that announcement doesn’t show is the 12-to-24-month operational reality behind it — a period in which the factory is neither reliably producing its old product nor its new one at full quality, while customers wait, workers retrain, and equipment that worked perfectly for one process has to be requalified, modified or replaced for another.

This matters more in solar than in most manufacturing sectors, because the industry’s technology cycle has genuinely accelerated. Mono PERC dominated Indian cell manufacturing for years; by 2026, roughly 70% of India’s installed module manufacturing capacity was based on TOPCon technology, with the remainder split between HJT and residual PERC lines. That shift didn’t happen overnight, and it didn’t happen without cost — for every line that switched, someone absorbed a transition period of reduced output, elevated scrap, and delayed customer deliveries.

Why This Isn’t “Just New Equipment”

A solar cell production line is not a set of independent machines bolted together. It is a tightly interdependent sequence — texturing, diffusion, passivation, metallisation, testing — where the output specification of one step is the input specification of the next. Changing the underlying cell technology changes the physics and chemistry at multiple steps simultaneously, not just one.

Moving from Mono PERC to TOPCon, for example, means adding a tunnel-oxide and doped-polysilicon layer to the rear of the cell — a step that doesn’t exist in a standard PERC process at all, requiring new deposition equipment (typically LPCVD or PECVD) and new furnace recipes for the additional thermal oxidation step. Moving toward HJT is a more fundamental change again, since it requires an entirely different deposition technology (PECVD amorphous-silicon layers) and low-temperature silver paste metallisation that cannot be co-fired the way PERC and TOPCon contacts are — a difference that shows up directly in cost, since HJT cells use silver loading 25-35% higher than TOPCon at a comparable busbar count, according to industry cost analysis.

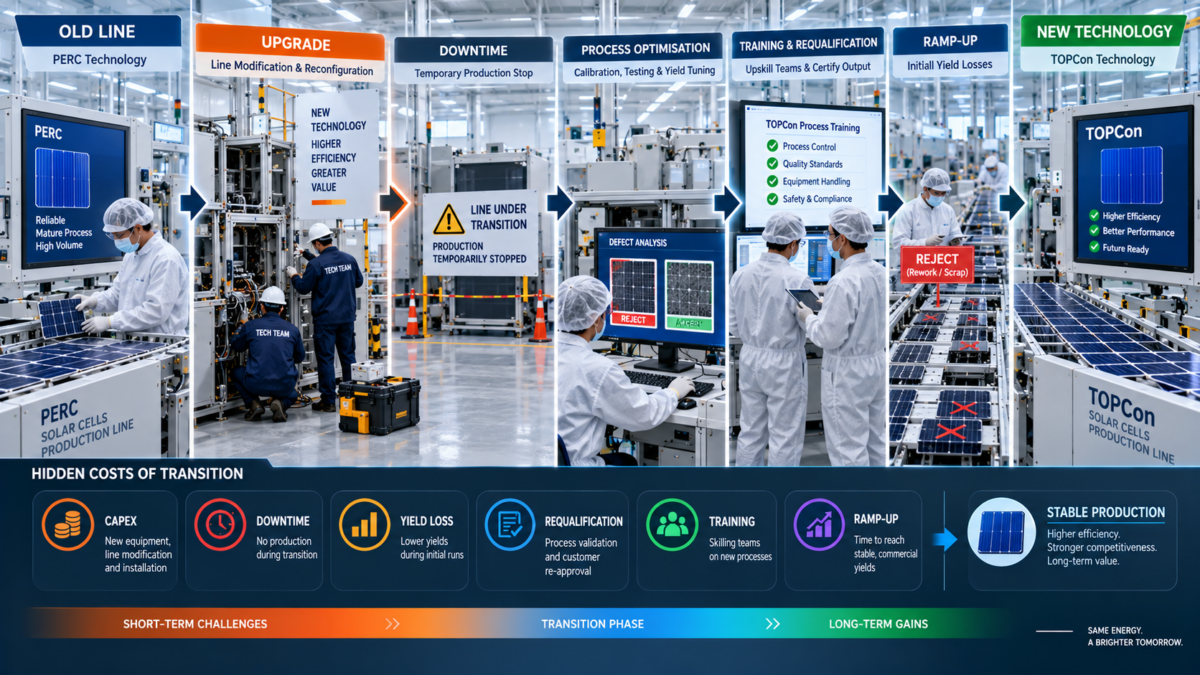

The Real Cost Categories of a Technology Transition

Existing equipment compatibility. Some tools in a PERC line — wafer handling, texturing baths, screen printers — can often be adapted or reused for TOPCon with modification. Others, particularly the tunnel-oxide deposition step, cannot be improvised from existing PERC tooling at all and require new capital equipment. The share of a line’s capital stock that is genuinely reusable versus stranded is one of the biggest hidden variables in any transition’s real cost.

CAPEX. New deposition tools, upgraded furnaces, and often upgraded screen-printing and firing equipment to handle different paste chemistries and firing profiles all represent capital spend beyond the “headline” cost of adding a technology. Cell manufacturing capital intensity is already high relative to module assembly — industry estimates put cell-line capital cost at roughly ₹250-400 crore per GW, versus ₹50-80 crore per GW for module assembly — and a technology transition adds to that base cost rather than replacing it outright when equipment can’t be repurposed.

Process recipe revalidation. Every furnace temperature profile, paste formulation, firing curve and cleaning-bath chemistry that was tuned for the old technology has to be re-derived for the new one. This isn’t a documentation exercise — it typically requires running real production batches, measuring outcomes, and iterating, which consumes both time and material.

Workforce retraining. Operators and process engineers who developed intuition for troubleshooting a PERC line’s specific failure modes need to build equivalent intuition for a new technology’s different failure modes — different defect signatures, different EL image patterns, different sensitivity points. This kind of tacit operational knowledge takes real production experience to rebuild, not just training sessions.

Yield ramp-up. New or converted lines almost universally start below the yield levels the old, mature line had achieved. Industry reporting on new Indian TOPCon capacity has noted that cell production lines typically take 18 to 24 months to reach stable yields after commissioning. During that ramp period, a factory is producing at below-design output, with a higher proportion of scrap and lower-bin product than it will eventually achieve.

Customer qualification. Module manufacturers and EPCs that buy cells from a given factory typically require re-qualification when the underlying cell technology changes — new samples, new testing, sometimes new bankability documentation for lenders and insurers. A factory can be technically capable of producing a new cell technology well before its major customers have finished requalifying it as an approved supplier for that product.

Supply continuity. A factory converting one line to a new technology while continuing to fulfil existing orders for the old technology has to manage the trade-off between converting quickly (accepting a bigger short-term output gap) and converting gradually (extending the period of reduced overall output while both processes run in parallel at reduced efficiency).

The Real Cost Categories of a Technology Transition

Why the Learning Curve Is the Hardest Part to Shortcut

Equipment can be purchased. Recipes can eventually be tuned through iteration. What is genuinely difficult to accelerate is the accumulated operational experience of running a specific line at scale — the pattern recognition that lets an experienced process engineer look at an EL image or an I-V curve and immediately know which upstream step is drifting. This is precisely the kind of expertise that underpins the batch-consistency and quality-control practices described in Websol’s article on EL testing, binning, PID, LID and batch consistency — and it is exactly this kind of tacit knowledge that has to be substantially rebuilt, not just transferred on paper, whenever the underlying process changes materially.

Automation can shorten some parts of this curve by reducing the variability introduced by manual handling and judgment calls, which is part of why automation investment — covered in Websol’s piece on how automation is reducing solar production costs — has become more, not less, important as technology cycles compress. But automation reduces variance around a process; it doesn’t replace the need to actually establish what the correct process parameters are for a new technology in the first place.

TOPCon, HJT and the Silver Cost Dimension of Transition

Technology transitions in solar today are rarely just about cell architecture — they usually carry a materials-cost dimension as well. TOPCon’s rise has been paired with steady reduction in silver consumption per cell through finer, more numerous busbars and improved paste formulations, a trend covered in Websol’s explainer on why silver matters in solar cell manufacturing. A factory transitioning toward HJT, by contrast, currently faces the opposite direction of travel on silver intensity, since HJT’s low-temperature paste requirements mean higher silver loading than TOPCon at a comparable busbar count. Any factory evaluating a transition has to weigh the technology’s efficiency and reliability advantages against this kind of structural materials-cost difference, not just the capital cost of new tooling.

For readers wanting the technology comparison itself rather than the transition mechanics, Websol’s existing guide on TOPCon vs Mono PERC vs HJT and its explainer on understanding solar cell technologies cover the electrical and commercial trade-offs between the technologies themselves.

A Practical Framework: What to Ask About a “Converted” Line

For anyone evaluating a cell supplier that has recently transitioned or is transitioning technology, the useful questions are less about the announced capacity and more about the operational reality behind it:

Question

Why it matters

How long has this specific line been running the new technology in volume production?

Directly informs where the line likely sits on its yield ramp-up curve

What share of the previous line’s equipment was reused vs newly purchased?

Indicates how much of the process had to be rebuilt from scratch

Has the factory been re-qualified by its major existing customers for the new cell type?

A technically capable line isn’t the same as a commercially validated supplier

What is the batch-to-batch consistency of recent shipments?

The clearest practical signal of how far along the yield ramp the line actually is

Key Takeaways

  • A cell technology transition changes physics and chemistry at multiple linked process steps simultaneously, not just one piece of equipment.
  • New cell technologies typically require 18-24 months after commissioning to reach stable yields.
  • Costs span new capital equipment, process recipe revalidation, workforce retraining, yield-ramp scrap, and customer re-qualification.
  • Materials cost structure (particularly silver) can shift meaningfully with a technology change, independent of the capital cost of transition.
  • The hardest part of a transition to shortcut is the accumulated operational experience needed to run the new process reliably at scale.

Frequently Asked Questions

Q: How long does it take to convert a Mono PERC line to TOPCon?

Beyond the physical installation of new deposition equipment, industry reporting suggests new or converted TOPCon lines typically take 18 to 24 months after commissioning to reach stable, mature production yields, even though some output is possible well before that point.

Some equipment — such as wafer handling, certain texturing and cleaning steps, and screen-printing tools — can often be adapted with modification. The tunnel-oxide and doped-polysilicon deposition step required for TOPCon has no equivalent in a standard PERC line and generally requires new capital equipment.

New process recipes take time to optimise, and a workforce experienced in troubleshooting the old technology’s failure modes needs time to build equivalent expertise for the new one. Both factors typically cause a temporary dip in yield and consistency during the ramp-up period.

Current industry cost analysis indicates HJT cells require roughly 25-35% higher silver loading than TOPCon at a comparable busbar count, along with slower deposition throughput, both of which contribute to HJT’s higher production cost per watt in most current Indian manufacturing setups.

Module manufacturers and EPCs typically require new samples, testing and sometimes updated bankability documentation whenever a cell supplier changes the underlying cell technology, since the electrical, thermal and reliability characteristics of the product have genuinely changed.

Not necessarily. A newly converted or commissioned line typically needs a meaningful ramp-up period before it reaches its design yield, so announced capacity and near-term available, quality-consistent output are not the same thing.

Can Old Solar Panels Become New Solar Materials? The Rise of PV Recycling in India

Can Old Solar Panels Become New Solar Materials? The Rise of PV Recycling in India

India’s first large wave of grid-connected solar capacity went up between roughly 2010 and 2015. Crystalline silicon modules are typically rated for 25–30 years of service, which means the earliest installations are still years away from mass retirement. But “years away” is not “irrelevant now” — module failures, damage, repowering projects and early decommissioning already generate PV waste today, and the regulatory and industrial infrastructure to handle it at scale is being built well ahead of the larger wave still to come.

This is not a story about environmental guilt. It is a story about an emerging industrial process: what a solar module is actually made of, what of that is worth recovering, and how close India currently is to doing that recovery at scale.

What a Solar Module Is Actually Made Of

A standard crystalline silicon module is, by weight, overwhelmingly glass and aluminium — the front glass sheet typically accounts for around two-thirds of a module’s mass, and the aluminium frame for another significant share. The remainder is a mix of encapsulant (EVA or POE), backsheet polymer, copper interconnect ribbons, a junction box, and the silicon cells themselves, which contain small but valuable quantities of silver in their metallisation paste.

None of these materials are worthless once separated, but none of them are trivial to separate either. That tension — genuinely recoverable value locked inside a laminated, glued, multi-material sandwich — is the central engineering and economic problem of PV recycling.

Glass is the largest recoverable stream by weight and, in principle, the easiest to recycle — but glass bonded to EVA encapsulant and a backsheet cannot simply be crushed and sent to a standard glass furnace without delamination first, or it contaminates the recycled glass stream.

Aluminium frames are the most straightforward component to recover, since they are mechanically fastened rather than laminated, and aluminium recycling is a mature, high-value process across most industries — this is one of the more genuinely economic legs of PV recycling today.

Silicon from the cells themselves can theoretically be recovered and reprocessed, but doing so to a purity level useful for new cell production is technically demanding and not yet widely commercially deployed in India at scale; more often, recovered silicon-containing material is downgraded into lower-value applications.

Silver, present in small quantities in cell metallisation, is disproportionately valuable relative to its mass and is one of the stronger economic incentives in module recycling — the same silver-cost pressure that is pushing manufacturers to reduce silver consumption per cell during production, as covered in Websol’s article on why silver matters in solar cell manufacturing, is the same dynamic that makes silver recovery from scrap modules economically meaningful.

Copper interconnects are recoverable through standard e-waste processing routes and add modest additional value.

solar cell material

Repair, Reuse, or Recycle: Not Every Retired Module Needs to Be Shredded

End-of-life is not the only reason a module leaves service, and it’s worth separating the pathways clearly:

  • Repair applies to modules with a fixable, localised fault — a damaged junction box or a single failed bypass diode — where the underlying cells and laminate are otherwise sound.
  • Reuse (secondary market) applies to modules retired early for reasons unrelated to performance, such as a repowering project replacing older, lower-wattage panels with newer high-efficiency ones. These modules may still have significant remaining useful life for lower-stakes applications.
  • Recycling is the appropriate pathway only once a module has reached genuine end of life — physically damaged beyond repair, or degraded below a usable performance threshold.

Treating recycling as the default pathway for every retired module both overstates the current waste volume and understates the value that can be recovered through simple reuse first.

Why PV Waste Is a Distinct Regulatory Category in India

Solar PV waste in India is regulated as a category under the E-Waste (Management) Rules, but it has historically been treated differently from most other e-waste categories. In March 2026, the Central Pollution Control Board (CPCB) released updated guidelines specifically for the safe storage, handling and transportation of discarded solar PV modules, panels and cells. According to CPCB’s published guidance, the current regulatory framework does not apply recycling targets to waste solar modules, panels or cells, unlike most other e-waste categories, which operate on an Extended Producer Responsibility (EPR) basis requiring producers to meet recycling targets by purchasing EPR certificates from registered recyclers.

Instead, the March 2026 CPCB guidelines assign a narrower set of obligations to manufacturers, producers and recyclers of solar PV equipment: mandatory registration, adherence to CPCB standard operating procedures for storage and transport, annual return filings, and a requirement to store solar waste responsibly until financial year 2034-35 — the point from which full recycling obligations are expected to apply. The guidelines are explicit that solar waste must never be dumped in open areas or sent to landfill, and that recycling, when it does happen, must go only through registered recycling facilities using covered transport to prevent breakage and contamination in transit.

This is, in effect, a deliberate two-stage regulatory approach: build the storage, tracking and registration infrastructure first, while actual retirement volumes are still relatively modest, and phase in binding recycling targets later as the volume of end-of-life material grows. Industry analysts widely read the March 2026 guidelines as the precursor to a fuller solar-specific EPR framework, expected sometime around 2027-2028.

PV Waste Is a Distinct Regulatory Category in India

The Scale of the Problem Ahead

The reason regulators are moving now, even though the current waste volume is manageable, is the shape of the curve ahead. India’s installed solar base has grown from a low base to well over 100 GW within about a decade, and a large share of that capacity was installed in the last five years. Since panels are rated for 25-30 years, the bulk of India’s current installed base won’t reach natural end-of-life until the late 2040s and beyond — but damage, defects, repowering and early failures already generate a meaningful and growing waste stream well before then, and that stream will only accelerate as the first large installation cohorts age.

This is precisely the situation in which regulatory frameworks tend to be built ahead of the peak — put the registration, storage and traceability rules in place while volumes are still manageable, so that the recycling industry has time to mature before mandatory targets and larger volumes arrive together.

Technical and Economic Challenges Facing Indian PV Recycling Today

Technical challenges. Delamination — separating the glass, encapsulant, cells and backsheet from each other — remains the hardest and most energy-intensive step in the recycling chain. High-value material recovery (particularly silicon and silver at usable purity) typically requires more sophisticated processing than glass and aluminium recovery, and that processing capacity is still limited in India relative to the eventual scale needed.

Economic challenges. Recycling economics depend heavily on collection logistics — modules are geographically dispersed across rooftop and utility-scale sites, and the cost of collecting and transporting them to a processing facility can exceed the value of the materials recovered, particularly for smaller rooftop volumes. Without mandatory recycling targets in place yet, there is currently limited regulatory pressure forcing collection and processing volumes to scale ahead of natural demand.

Regulatory transition risk. Manufacturers and recyclers now operating under the 2026 storage-and-registration rules will need to adapt again once binding recycling targets and EPR certificate trading are phased in around 2027-2028, which creates near-term compliance uncertainty even as it signals the direction of travel clearly.

Where the Opportunity Sits

None of this changes the fact that a growing base of glass, aluminium, copper and silver is accumulating in India’s fields and rooftops, waiting for a processing pathway that doesn’t yet exist at the scale the country will eventually need. For manufacturers, this is connected to the broader push toward sustainability already underway in cell and module production — covered in more detail in Websol’s article on the environmental cost of solar manufacturing — since reducing the material and energy intensity of new production and building a viable recovery pathway for old modules are two sides of the same circular-economy problem. It also sits alongside India’s broader manufacturing self-reliance story: the same instinct that pushed India to build domestic cell and module capacity, described in Websol’s piece on India’s solar manufacturing journey, is likely to eventually extend upstream into recovering domestic material inputs rather than only importing virgin silicon, silver and aluminium.

Key Takeaways

  • A crystalline silicon module is mostly glass and aluminium by weight, with smaller but valuable amounts of copper and silver.
  • CPCB’s March 2026 guidelines require registration, safe storage and transport for solar PV waste, but do not yet impose mandatory recycling targets.
  • Full EPR-style recycling obligations for solar waste are expected around 2034-35, with industry expecting an earlier framework closer to 2027-2028.
  • Repair and reuse should be considered before recycling for modules retired early rather than at genuine end of life.
  • Collection logistics, not just processing technology, is currently the biggest economic constraint on scaling PV recycling in India.

Frequently Asked Questions

Q: Are solar panels required to be recycled in India right now?

Not under a mandatory recycling target. CPCB's March 2026 guidelines require producers and recyclers to register, store waste safely, and hand it only to registered recycling facilities, but binding recycling targets for solar PV waste are not yet in force.

Glass and aluminium make up the largest share by weight and are the most straightforwardly recoverable. Copper interconnects and silver from cell metallisation are recoverable in smaller quantities but carry disproportionate value relative to their mass.

No. CPCB guidelines explicitly prohibit dumping solar waste in open areas or landfills, since panels can contain materials that pose environmental risks if not managed properly, and require waste to go through registered recyclers via approved storage and transport procedures.

Since crystalline silicon modules are typically rated for 25-30 years and the bulk of India’s installed base was added in roughly the last decade, most current capacity will not reach natural end-of-life until the late 2040s and beyond — though damage, defects and repowering already generate a smaller waste stream well before then.

Reuse means a still-functional module is redeployed, often after being replaced in a repowering project, whereas recycling means a module has reached genuine end of life and is processed to recover its constituent materials.

Regulators appear to be building the registration, storage and traceability infrastructure first, while current waste volumes are still relatively low, with the intention of phasing in mandatory recycling obligations as volumes grow — full targets are expected from 2034-35 under current CPCB guidance.

Solar Module Traceability in India: How Cell-to-Module Tracking Is Changing PV Procurement

Solar Module Traceability in India: How Cell-to-Module Tracking Is Changing PV Procurement

A module label can say almost anything. A serial number, by contrast, points to a specific manufacturing record. That distinction — between a claim and a verifiable record — is what traceability in solar manufacturing is actually about, and it has quietly become one of the more consequential compliance issues in Indian solar procurement over the past two years.

Traceability is often discussed as if it were simply another name for Domestic Content Requirement (DCR) compliance. It isn’t. DCR is a policy rule about where a cell must be made. Traceability is the infrastructure that lets anyone — a government scheme administrator, an EPC, a lender, or an end customer — actually verify that the rule was followed for a specific, individual module, rather than trusting a general vendor declaration.

What PV Traceability Actually Means

Traceability in solar manufacturing covers the ability to answer three linked questions for any given module:

  1. Which cell manufacturer, factory and production batch produced the cells inside this module?
  2. Which module assembly facility, production line and date built this specific module?
  3. Can this chain of custody be verified independently, using a serial number, rather than taken on the seller’s word?

This requires more than a label. It requires digital manufacturing records — cell batch data, module assembly logs, and a serialisation system that ties a physical unit back to those records — held by a body that both the manufacturer and the buyer trust.

PV Traceability

Serialisation and Cell-to-Module Tracking

Every module produced for a scheme requiring DCR compliance is expected to carry a unique serial number. That number is not decorative. It is the index key that links the physical module in the field back to the manufacturing data submitted by the producer: which cell batch went into it, which line assembled it, and when.

This is what “cell-to-module tracking” means in practice — the record isn’t just “this module was made in India,” it is “these specific cells, from this specific cell manufacturer’s batch, were assembled into this specific module, on this date, at this facility.” That level of granularity is what makes DCR verification meaningful rather than a paperwork exercise, and it is the reason Websol’s existing guide on DCR vs non-DCR solar cells is worth reading alongside this one — that article explains the policy distinction; this one explains how it is actually verified.

How India’s DCR Verification Ecosystem Works

India’s traceability infrastructure for solar is centred on the National Institute of Solar Energy (NISE), an autonomous institution under the Ministry of New and Renewable Energy (MNRE), which operates the DCR Verification Portal. According to NISE’s own portal documentation, the system works through a four-step process: cell and module manufacturers, along with resellers and EPC companies, register on the portal with company and PAN details; manufacturers submit cell and module manufacturing data including unique serial numbers, specifications and invoice details; NISE then verifies the domestic manufacturing data, traces the cell-to-module mapping, and validates ALMM compliance.

For a buyer or auditor, this means a specific module’s DCR certificate — or its serial number — can be checked directly against this record, rather than relying on the manufacturer’s paperwork alone. The portal also allows verification of the authenticity of any DCR certificate using the certificate number or a QR code scan, per NISE’s published system description.

This infrastructure has become more consequential, not less, as scrutiny has increased. In May 2026, MNRE tightened rules under PM Surya Ghar specifically to address gaps in the previous system: the ministry announced that installations containing repeated solar module or inverter serial numbers would no longer be accepted based on vendor undertakings alone for applications submitted after 26 May 2026, integrating the residential rooftop scheme’s National Portal more tightly with the NISE DCR verification system. The change was a direct response to the fact that duplicate or reused serial numbers had been allowed through on manual vendor declarations — precisely the kind of gap that a genuine serialisation and verification system is meant to close.

DCR verification eco system

Why This Matters Beyond Government Schemes

It would be a mistake to treat traceability as a compliance checkbox that only matters for PM Surya Ghar, CPSU Phase-II or PM-KUSUM projects. It has commercial value in several other situations:

Warranty claims. When a module underperforms or fails within its warranty period, the manufacturer needs to identify the specific production batch to determine whether the issue is isolated or systemic. Without serialisation tied to batch records, warranty investigations rely on visual inspection and manufacturer goodwill rather than data.

Product recalls. If a defect is traced to a specific cell batch or assembly period, a manufacturer with proper traceability can identify exactly which modules, at which project sites, need inspection — rather than issuing a blanket recall or, worse, being unable to identify the affected population at all.

Quality investigations. EPCs and asset owners increasingly want batch-level data when diagnosing field issues like degradation clusters, hot spots or early failures, particularly on large utility-scale portfolios where even a small defect rate translates into a meaningful number of affected modules.

Counterfeit and relabelled products. A serialisation system that ties back to verified manufacturing records makes it far harder to relabel imported or non-compliant cells as DCR product, because the serial number itself is checked against submitted manufacturing data rather than simply printed on a sticker.

Procurement verification. For distributors, EPCs and government tender evaluators, the ability to independently verify a module’s origin — rather than relying on a supplier’s self-declaration — reduces procurement risk on large contracts where DCR non-compliance can trigger penalties or subsidy rejection.

What Traceability Does Not Solve

It is worth being precise about the limits of the current system. NISE’s portal verifies that submitted manufacturing data is consistent and that serial numbers are not duplicated or fabricated — but the credibility of that data still depends on manufacturers submitting accurate records in the first place. Traceability infrastructure reduces the opportunity for undetected misrepresentation; it does not eliminate the need for manufacturers to have genuinely reliable internal quality and batch-tracking systems, of the kind described in Websol’s article on solar module quality certifications. Certification (IEC, BIS) verifies that a module design and sample meet a technical standard; traceability verifies that a specific unit corresponds to the manufacturing claims made about it. Buyers need both.

A Practical Verification Checklist for Buyers

Step

What to check

Why it matters

1

Is the manufacturer registered on the NISE DCR Verification Portal?

Confirms the manufacturer participates in the formal traceability system at all

2

Does the module carry a unique, non-repeated serial number?

Basic prerequisite for any traceability claim

3

Can the DCR certificate be verified via the portal’s certificate/QR lookup?

Independently confirms the certificate is genuine, not just printed

4

Is the module ALMM-listed under the correct list (I or II) for the scheme in question?

ALMM listing and DCR compliance are related but separate checks

5

Does the manufacturer hold relevant module quality certifications (IEC 61215/61730, BIS)?

Traceability confirms origin; certification confirms design and build quality — see Websol’s guide on what buyers must verify

6

For subsidy-linked residential projects, is the installation compliant with the tightened serial-number rules introduced in May 2026?

Directly affects PM Surya Ghar subsidy eligibility

For readers evaluating suppliers more broadly rather than a single shipment, Websol’s complete guide to solar cell manufacturers in India and its guide on PM Surya Ghar panel qualification are useful companion reading, since traceability is one input into a much larger supplier-evaluation process.

The Direction of Travel

Traceability systems tend to move in one direction once introduced: toward more granularity, not less. The May 2026 tightening of PM Surya Ghar rules is a useful signal of where this is headed — regulators are moving away from manual, vendor-declared compliance and toward systems where an individual unit’s history is checked against a central digital record by default. For manufacturers, this means internal batch and serialisation discipline is no longer just a quality-control nicety; it is close to a market-access requirement. For buyers, it means procurement due diligence increasingly needs a traceability check as a distinct line item, separate from certification and pricing.

Key Takeaways

  • Traceability is the infrastructure that lets a specific module’s origin be verified against manufacturing records — it is not the same as DCR policy itself.
  • India’s system is coordinated through NISE’s DCR Verification Portal, which links serial numbers, cell batch data and module assembly records.
  • MNRE tightened enforcement in May 2026, closing a loophole that had allowed vendor-declared serial numbers without independent verification.
  • Traceability supports warranty claims, recalls, quality investigations and anti-counterfeiting, well beyond simple scheme compliance.
  • Traceability and certification answer different questions and buyers need both.

Frequently Asked Questions

Q: Is solar module traceability the same as DCR compliance?

No. DCR compliance is the policy requirement that cells and modules be made in India for certain government-supported projects. Traceability is the verification infrastructure — serial numbers, manufacturing records and the NISE portal — that allows DCR compliance to actually be checked for a specific unit rather than assumed from a supplier's declaration.

The module’s DCR certificate number or QR code can be checked directly on the NISE DCR Verification Portal, which will confirm whether the certificate corresponds to genuine submitted manufacturing data for that unit.

The ministry identified that the earlier system allowed installations with repeated or duplicate module and inverter serial numbers to be accepted based on vendor undertakings, which undermined the accuracy of subsidy and compliance records. The May 2026 change requires closer integration with the NISE DCR verification system for new applications.

ALMM listing confirms that a module model and manufacturer are approved for government-supported projects, but it is a model-level and manufacturer-level approval. Traceability through the DCR portal operates at the level of the individual serialised unit, which is a more granular check.

If a manufacturer can trace a failed module back to its specific cell batch and assembly date, it can determine whether a defect is isolated or affects a wider batch, which materially changes how a warranty claim and any related field investigation are handled.

The formal DCR verification infrastructure is built primarily around scheme compliance (PM Surya Ghar, PM-KUSUM, CPSU Phase-II and DCR-mandated tenders), but the underlying serialisation and batch-record discipline it requires of manufacturers has value for any buyer wanting to verify product origin, regardless of scheme.

Why Solar Manufacturing Yield Matters: How Cell Production Losses Affect the Cost of Every Watt

Why Solar Manufacturing Yield Matters: How Cell Production Losses Affect the Cost of Every Watt

A gigawatt of “capacity” is not a gigawatt of product. It is a theoretical ceiling — the output a production line would generate if every wafer that entered the line came out the other end as a saleable, in-specification cell. In practice, no factory works that way. Wafers break. Cells fall outside efficiency bins. Metallisation misprints. Some units fail electroluminescence (EL) inspection and get scrapped or reworked. The gap between what a line could theoretically produce and what it actually ships is manufacturing yield, and it is one of the least discussed but most consequential numbers in the entire solar value chain.

Two factories can announce identical 1 GW annual capacity, buy the same tools from the same equipment vendors, and still end up with meaningfully different unit economics — because one runs at 97% yield and the other at 91%. That six-point gap doesn’t show up in a capacity announcement. It shows up in cost per watt, in delivery reliability, and eventually in the price a module maker or EPC pays for cells.

What “Manufacturing Yield” Actually Means

In solar cell production, yield is usually tracked at more than one stage:

  • Wafer-to-cell yield — the percentage of incoming wafers that survive processing (diffusion, texturing, passivation, metallisation) without breaking or being scrapped for defects.
  • Cell efficiency-bin yield — the percentage of finished cells that fall into the target efficiency and quality bins the factory is selling against, rather than being downgraded into lower-value bins or rejected outright.
  • Line/equipment yield (uptime) — how much of the scheduled production time the tools are actually running versus down for maintenance, recipe changeovers, or quality holds.

A factory’s effective output is the product of all three. A line with 98% wafer survival, 95% efficiency-bin pass rate and 92% equipment uptime is not running at “close to 100%” — its combined effective yield is closer to 86%. Multiply that gap across a full year of production and it becomes a large volume of silicon, chemicals, labour and depreciation that produced no sellable watt at all.

Where the Losses Actually Happen

Wafer breakage. Silicon wafers are thin — modern M10 and G12 formats are typically in the 130–160 micron range — and they pass through dozens of handling, loading and thermal-shock steps between an incoming wafer and a finished cell. Breakage tends to cluster around texturing/cleaning baths, diffusion furnace loading, and screen-printing alignment, where mechanical handling stress is highest.

Process losses. Diffusion uniformity, passivation layer quality (critical for TOPCon’s tunnel-oxide layer), and texturing consistency all affect how many cells land within the target electrical specification. A furnace running slightly outside its process window doesn’t necessarily produce a visibly broken cell — it produces a cell that quietly underperforms and gets binned lower or rejected at EL testing.

Metallisation losses. Screen-printing the front and rear metal contacts is one of the most yield-sensitive steps in the whole line. Misalignment, paste under- or over-application, and firing-profile drift all show up later as resistive losses, shading losses, or visible print defects — the kind of issues covered in detail in Websol’s explainer on EL testing, binning and batch consistency.

Efficiency distribution. Even a well-controlled line produces a spread of cell efficiencies, not a single number. A factory advertising “up to 22.8% efficiency” is describing its best bin, not its average output. The width of that distribution — how tightly clustered the cells are around the top bin — is itself a yield and process-control metric.

Rework and scrap. Not every deviation is a total loss. Some cells can be reworked (re-cleaned, re-fired, re-sorted); others are scrapped for material recovery. Rework consumes extra cycle time and energy without adding capacity, which is a hidden cost that doesn’t appear in headline GW figures.

Equipment uptime. Planned maintenance, unplanned breakdowns, and the time lost during recipe changeovers (for example, switching a line between cell formats or busbar counts) all reduce the number of wafers a line can process in a given year, independent of how well those wafers perform once processed.

Capacity vs Utilisation vs Yield

Capacity vs Utilisation vs Yield: Three Different Numbers

These three terms get used loosely in industry reporting, but they answer different questions:

Metric

What it answers

Why it matters

Nameplate capacity

What could this line theoretically produce per year, running continuously at design speed?

Used in capacity announcements and government tallies

Utilisation

What share of that theoretical capacity was actually run (line hours used vs available)?

Reflects demand, order books, and operational discipline

Yield

Of the wafers actually processed, what share came out as sellable, in-spec product?

Reflects process control, equipment maturity and workforce skill

India’s own manufacturing data illustrates why this distinction matters at a national level, not just a factory level. By the end of 2025, India’s cumulative module manufacturing capacity had reached roughly 210 GW, while cell manufacturing capacity stood at around 27 GW — a stark reminder that installed capacity figures say nothing about how much of that capacity is running, at what yield, and against what quality standard. A national capacity number is a policy signal; it is not a production forecast.

Why Two Identical-Capacity Factories Can Have Very Different Economics

Imagine two 2 GW/year cell lines, built with comparable tooling, both quoted at the same headline capacity.

  • Factory A runs at 93% equipment uptime, 97% wafer survival and a tight efficiency distribution concentrated in its top two bins. Its effective sellable output is close to 1.85 GW/year of premium-bin product.
  • Factory B runs at 85% uptime (more unplanned downtime, slower changeovers), 92% wafer survival, and a wider efficiency spread with a larger share of cells falling into lower bins. Its effective sellable output might land closer to 1.55 GW/year, with a meaningfully higher proportion sold at a discount.

The two factories consumed almost the same amount of silicon, chemicals, electricity and depreciation to get there. Factory B’s real cost per watt is higher — not because its equipment was worse, but because a larger share of its inputs never became a sellable watt. This is the central reason procurement teams evaluating cell suppliers should ask about yield and batch consistency, not just quoted efficiency, a point developed further in Websol’s guide to choosing a solar cell supplier.

How Process Control and Automation Improve Yield

Yield improvement is rarely one dramatic fix — it is usually the accumulation of many small process-control gains:

  • Statistical process control (SPC) on furnace temperature profiles, paste deposition weight, and texturing bath chemistry catches drift before it produces a batch of out-of-spec cells.
  • Automated material handling reduces the mechanical stress events that cause wafer breakage, since robotic wafer transfer is more repeatable than manual handling. Websol’s own account of how automation is reducing solar production costs covers this in more depth.
  • In-line EL and I-V testing at multiple stages (not just final inspection) allows defects to be caught and corrected earlier in the process, before more value has been added to a bad wafer.
  • Recipe standardisation across shifts and operators reduces the variability that comes from human judgment calls on borderline units.
  • Preventive maintenance scheduling, rather than run-to-failure maintenance, protects uptime — the “utilisation” side of the yield equation.

None of these are exotic. What separates high-yield fabs from average ones is usually discipline and measurement — a willingness to track yield loss by process step, rather than reporting a single blended number.

Module Economics and Procurement Risk

Why Yield Ultimately Decides Module Economics and Procurement Risk

For a module manufacturer or EPC buying cells, a supplier’s yield discipline shows up indirectly, in ways that matter commercially:

  • Batch-to-batch consistency. Low-yield fabs tend to have wider quality variation between batches, which complicates module binning and can affect string-level mismatch losses downstream — a topic covered in Websol’s explainer on the cell-to-module efficiency gap.
  • Delivery reliability. A fab running near its yield ceiling has less buffer to absorb a bad batch without missing a shipment date.
  • Price stability. Suppliers with structurally low yield have less margin to absorb input cost volatility (silicon, silver, energy), which can translate into more volatile quoted prices — and silver consumption in particular is a growing share of cell cost, as explained in Websol’s article on why silver matters in solar cell manufacturing.
  • Long-term reliability signal. A cell factory with mature process control and tight efficiency binning is also more likely to have consistent electrical characteristics across the module’s operating life — relevant to anyone evaluating how solar cells are manufactured and where quality is actually built in.

Key Takeaways

  • Manufacturing yield is the share of processed wafers that become sellable, in-spec cells — it is distinct from nameplate capacity and from utilisation.
  • Losses accumulate across wafer handling, diffusion/passivation, metallisation, binning and equipment uptime.
  • Two factories with identical GW capacity can have meaningfully different real costs per watt if their yields differ.
  • Automation, statistical process control and in-line testing are the main levers for improving yield.
  • For buyers, a supplier’s yield discipline is a proxy for delivery reliability and batch consistency, not just headline efficiency.

Understanding manufacturing yield is one part of evaluating any solar cell supplier’s real capability — alongside process transparency, batch consistency and quality documentation. Websol Energy System Ltd, an Indian solar cell manufacturer, shares its own manufacturing practices and process details for buyers who want to look beyond headline capacity numbers when evaluating cell suppliers.

Frequently Asked Questions

Q: What is a "good" yield for a solar cell manufacturing line?

Mature, well-run TOPCon lines in India are generally reported in the mid-90s to upper-90s percentage range for combined wafer-to-cell yield, while newer or less-optimised lines — including newer HJT lines still climbing their learning curve — can run several points lower. There is no single universal benchmark because yield definitions vary by manufacturer; what matters more is the trend over time and consistency batch to batch.

No. Efficiency describes how well the best cells convert sunlight into electricity; yield describes what share of all processed wafers reach a sellable specification at all. A line can produce very high peak efficiency in its top bin while still losing a significant share of wafers to breakage or rejects elsewhere in the process.

Cell manufacturing is far more capital- and process-intensive than module assembly, and new cell lines typically need an extended ramp-up period to reach stable yields after commissioning. This is a major reason India’s cell capacity has expanded more slowly than its module capacity, even with strong policy support.

Indirectly, yes. Wider variation in cell efficiency and electrical characteristics from a lower-yield fab can complicate module-level cell matching and binning, which affects mismatch losses in the finished module — separate from, but related to, the yield question itself.

Utilisation measures how much of a line’s available production time was actually used; yield measures how much of what was actually processed turned into a good product. A factory can have high utilisation (running constantly) but still have low yield if a large share of that output is scrapped or downgraded.

Automation generally reduces the mechanical-handling and human-variability sources of yield loss, but it is not automatic — poorly maintained or badly calibrated automated equipment can introduce its own systematic defects. Yield improvement from automation depends on how well the automated process is monitored and controlled.

India’s Solar Manufacturing Supply Chain: From Polysilicon to Wafer, Cell & Module

India's Solar Manufacturing Supply Chain: From Polysilicon to Wafer, Cell & Module

India can now assemble more solar modules in a year than almost any country outside China. What it can’t yet do, at meaningful scale, is make the raw materials that go into those modules. Understanding exactly where the gaps sit in the five-stage solar value chain — and why they matter for procurement risk — is essential context for anyone sourcing solar equipment in India today.

Quick Answer

Solar manufacturing runs through five sequential stages: polysilicon refining, ingot growth, wafer slicing, cell manufacturing, and module assembly. India has built substantial capacity at the downstream module stage (~200 GW) but remains heavily import-dependent at every upstream stage — nearly all of India’s polysilicon requirements continue to be imported, and wafer imports also remain overwhelmingly dependent on China. This “inverted pyramid” — strong downstream capacity, weak upstream capacity — is the structural reason behind ALMM List-II, the coming ALMM List-III for wafers, and the cell supply constraints EPCs are navigating through 2026.

The Five Stages of Solar Manufacturing

Stage

What Happens

India’s Current Position (2026)

1. Polysilicon

Metallurgical-grade silicon refined to solar-grade purity (99.9999%+)

~2 GW capacity, ~90% import reliance

2. Ingots

Purified silicon melted and grown into single-crystal cylindrical ingots

Near-zero standalone capacity

3. Wafers

Ingots sliced into thin wafers (e.g., M10, G12 formats)

First domestic ingot-and-wafer facility commissioned in FY25 at ~2 GW initial capacity

4. Cells

Wafers processed (diffusion, PECVD, screen-printing) into functioning solar cells

Domestic cell manufacturing capacity has crossed 30 GW

5. Modules

Cells interconnected, laminated with glass/EVA/backsheet, framed

Module manufacturing capacity has crossed 200 GW annually

Why the Chain Is So Lopsided

Despite reaching a nominal module capacity of 172 GW by Q1 2026, India’s local supply chain exhibits an asymmetrical, “inverted pyramid” structure, with upstream and midstream capacities lagging severely behind downstream assembly. The reasons compound at each stage moving upstream:

Capital intensity increases sharply. Module assembly is comparatively capital-light and can be commissioned relatively quickly. Cell manufacturing requires significantly more specialised equipment and process expertise. Wafer and ingot production, and especially polysilicon refining, require enormous capital investment, longer commissioning timelines, and highly specialised technical know-how that India has historically had limited domestic experience with.

China’s structural dominance compounds the gap. China accounts for over 80 percent of global manufacturing capacity across the solar value chain, while controlling more than 95 percent of global wafer production, and Chinese manufacturers continue to dictate global supply and pricing in polysilicon specifically. Globally, the solar PV manufacturing supply chain is dominated by China, with over 90 percent share in polysilicon and wafer manufacturing capacity, over 85 percent share in cells, and around 80 percent share in modules. New entrants at any upstream stage are competing against an incumbent with two decades of accumulated scale economics.

Policy incentives arrived downstream-first. India’s manufacturing-linked incentive schemes and the original ALMM List-I framework targeted module manufacturing years before equivalent structural support existed for cells, wafers, or polysilicon — which is a large part of why capacity built up in that order.

The Momentum Building Upstream

The picture is not static. FY25 marked an important structural milestone with the commissioning of India’s first ingot and wafer manufacturing facility, with an initial capacity of 2 GW, and the country is at the cusp of commencing domestic polysilicon production, with major fully integrated manufacturing facilities expected to come online between FY26 and FY28. Several large players — including Tata Power, Adani Solar, and Waaree — have announced plans to set up ingot and wafer manufacturing capacities in phases.

Policy is following the same upstream trajectory. Beyond ALMM List-II for cells, MNRE expanded the ALMM framework in March 2026 to include solar ingots and wafers under a new ALMM List-III, effective from June 1, 2028  — with the explicit intent of pulling backward integration investment upstream the same way List-I and List-II did for modules and cells.

Some manufacturers are moving proactively rather than waiting for the mandate. Websol Energy System, for instance, has outlined its own backward-integration roadmap toward ingot and wafer production — details of which are covered in our dedicated piece on Websol’s backward integration strategy.

What the Gap Means for EPCs and Developers Right Now

Cell-stage risk is the most immediate and practical concern. Domestic cell manufacturing currently meets only about 25–30 percent of demand, resulting in a sizeable gap in the upstream value chain  — this is the layer most likely to directly affect your project timelines today. We’ve covered this specific risk, and how to plan around it, in India’s solar cell supply crunch.

Wafer-stage exposure is a medium-term consideration. With ALMM List-III not mandatory until June 2028, wafer sourcing isn’t yet a compliance issue — but manufacturers who are building supplier relationships now, ahead of the mandate, will be better positioned when it activates. MNRE has indicated it will only publish ALMM List-III once at least three independent wafer manufacturers are operational in India with combined capacity of 15 GW per annum — a threshold that itself signals how early-stage this segment of the supply chain remains.

Polysilicon-stage exposure is largely indirect but still relevant to pricing. As the input furthest upstream, polysilicon supply and pricing dynamics (heavily influenced by Chinese production economics) flow through the entire chain and eventually affect wafer, cell, and module pricing even for buyers who never interact with polysilicon suppliers directly.

Why Vertical Integration Is Becoming a Genuine Differentiator

In a supply chain this lopsided, a manufacturer’s position on the value chain map is a legitimate procurement consideration, not just a corporate narrative point. A company manufacturing its own cells — rather than depending on third-party cell supply in a capacity-constrained market — removes an entire layer of upstream risk exposure that pure module assemblers currently carry.

Websol Energy System Limited operates at the cell and module manufacturing stages, producing its own M10 Bifacial Mono-PERC cells rather than depending on external cell supply, with additional backward-integration plans extending toward ingot and wafer manufacturing. Current product specifications are available on the Websol solar cell page and solar module page.

Frequently Asked Questions

What are the five stages of the solar manufacturing supply chain, in order?

Polysilicon refining, ingot growth, wafer slicing, solar cell manufacturing, and module assembly — silicon moves from raw purified material through each stage before becoming a finished, sellable solar panel.

Polysilicon and wafer manufacturing represent India’s most significant supply chain gaps, with capacity still in early stages compared to the cell and, especially, module manufacturing stages.

Two decades of sustained capital investment, government industrial policy support, and accumulated technical expertise across every stage of the value chain have given Chinese manufacturers structural cost and scale advantages that are difficult for new entrants to match quickly.

ALMM List-III is a proposed extension of India’s Approved List of Models and Manufacturers framework to cover solar wafers, with compliance requirements proposed to begin June 1, 2028, contingent on sufficient domestic wafer manufacturing capacity being operational first.

Momentum is building — with the first domestic ingot/wafer facility now commissioned and several major manufacturers announcing backward-integration plans — but closing the gap meaningfully, particularly at the polysilicon stage, is widely expected to take several years given the capital intensity and technical complexity involved.

Why Silver Matters in Solar Cell Manufacturing — and How Manufacturers Are Reducing Silver Consumption

Why Silver Matters in Solar Cell Manufacturing — and How Manufacturers Are Reducing Silver Consumption

Silver isn’t a minor input in solar cell manufacturing — it’s one of the largest cost drivers procurement teams rarely ask about. When silver prices swing, cell prices follow, often faster than developers expect. Understanding why silver is used at all, and how the industry is working to use less of it, is genuinely useful context for anyone negotiating cell or module supply in the current market.

Quick Answer

Silver paste is used to print the fine conductive grid lines (fingers and busbars) that collect electrical current from a solar cell’s surface — no cost-effective, high-conductivity alternative has fully replaced it at scale yet. Silver paste now accounts for up to 30 percent of total solar cell production costs, and with silver prices at record highs through 2025–26, manufacturers across the industry have been aggressively “thrifting” — reducing silver use per cell through thinner printing, tighter tolerances, and technology shifts — even as total industry silver demand keeps climbing due to overall solar deployment growth.

Why Solar Cells Need Silver At All

A solar cell generates current across its entire surface, but that current needs to be collected and routed to the cell’s edge for connection into a module circuit. This is done through a printed metallic grid — fine “finger” lines and larger “busbars” — and silver is used because it offers the best available combination of high electrical conductivity and compatibility with the low-temperature, high-throughput screen-printing processes used in mass cell manufacturing.

Copper is more abundant and far cheaper, but pure copper paste solutions have historically struggled with adhesion, oxidation, and print-quality issues at the temperatures and speeds solar manufacturing requires. Pure copper paste solutions are not yet technically mature — which is precisely why silver, despite its cost, has remained the industry’s default metallization material.

The Scale of the Silver Problem

Solar panel manufacturing consumed 186.6 million ounces of silver in 2025, while global mine production totaled 846.6 million ounces — meaning the photovoltaic industry alone used approximately 22 percent of all silver mined worldwide. That’s an extraordinary concentration of a single global commodity flowing into a single industrial application.

Pricing has responded accordingly. Silver futures hit a record high overnight, reaching $80 an ounce for the first time at the end of December 2025. A separate record was noted at $83.62 per ounce on December 28 as the price surge continued into early 2026. Solar module manufacturers in India currently have limited ability to raise panel final prices, which is accelerating efforts to reduce silver use across all mainstream cell technologies.

Silver Consumption by Cell Technology

Cell Technology

Approx. Silver Use (mg/cell or mg/W)

Trend

TOPCon

~86 mg per cell (down 21.1% y-o-y per CPIA 2025 data)

Declining, active thrifting focus

HJT (heterojunction)

~75 mg per cell, down 34.8% y-o-y — lowest among mainstream n-type technologies

Declining fastest among n-type

Back-contact (BC)

~135 mg per cell, remains the highest among mainstream technologies

Highest, thrifting harder due to design complexity

Mono-PERC

Historically ~9 mg/W baseline, with continued reduction efforts

Declining, mature thrifting curve

Figures reflect industry-reported estimates as of early-to-mid 2026 and vary by manufacturer, process generation, and reporting methodology.

How Manufacturers Are Cutting Silver Use

Thrifting through process optimisation. Manufacturers achieve reduced silver use through thinner paste layers, tighter printing tolerances, and more efficient cell designs — this is the primary near-term lever, requiring no fundamental materials change, just tighter process control over existing screen-printing equipment.

Silver-coated copper paste. Silver-coated copper pastes are currently the most effective immediate approach to reducing silver consumption, though they do not eliminate silver use entirely — this hybrid approach uses a thin silver coating over a copper core, cutting the actual silver content substantially while retaining much of silver’s conductivity and print-process compatibility. This approach can reduce silver content by around 70 percent and is approaching mass-production viability in heterojunction cell manufacturing specifically.

Research-stage breakthroughs. At the far end of the innovation curve, Fraunhofer ISE researchers have succeeded in producing highly efficient silicon heterojunction solar cells with a minimal silver consumption of only 1.4 milligrams of silver per watt of peak power using screen printing for the solar cell metallization — undercutting the 2 mg/W long-term sustainability target calculated for global PV production at multi-terawatt scale. This remains a lab-scale result rather than mass-production reality, but it demonstrates how much headroom exists below current industry-average consumption figures.

Why “Less Silver” Doesn’t Mean “Solved”

Here’s the genuinely counterintuitive part of this story, and it matters for anyone tracking input-cost risk: solar photovoltaic manufacturers reduced silver consumption by 19% in 2026, cutting demand from 186.6 million ounces in 2025 to roughly 151 million ounces — yet the global silver market is still heading for its sixth consecutive annual supply deficit. When both silver demand and supply-side constraints move at a similar pace, the underlying deficit doesn’t actually shrink — it can even widen.

The practical implication: thrifting is reducing solar’s per-watt silver intensity meaningfully, but total industry silver demand is still rising in absolute terms because global solar deployment volumes are growing faster than the rate of per-cell silver reduction. This means silver price risk isn’t a temporary spike that thrifting will fully resolve — it’s a structural cost factor procurement teams should expect to keep managing over the medium term.

What This Means for Cell and Module Buyers

Ask suppliers about their silver-use trajectory, not just current pricing. A manufacturer actively investing in silver-coated copper paste or advanced printing processes is better positioned to absorb future silver price volatility without passing the full impact to buyers.

Expect cell pricing to remain sensitive to silver spot prices. With silver representing up to 30% of cell production cost, any multi-year supply contract should account for how silver price movement is handled — fixed pricing, indexed pricing, or periodic renegotiation clauses are all worth clarifying upfront.

Understand that technology choice affects silver exposure. Back-contact cells currently carry the highest silver intensity among mainstream technologies, which is a relevant factor — alongside efficiency and cost — when comparing cell technology options for a given project.

Mono-PERC technology, which Websol Energy System uses for its M10 Bifacial cells, sits toward the lower end of the silver-intensity spectrum among current mainstream cell technologies, reflecting a mature thrifting curve built over years of process refinement. Readers comparing cell technologies more broadly may find our piece on Mono-PERC versus TOPCon cells a useful companion read.

Frequently Asked Questions

Why can't manufacturers just switch entirely to copper instead of silver?

Pure copper paste currently faces technical challenges around adhesion, oxidation resistance, and compatibility with high-speed screen-printing processes at the temperatures solar manufacturing requires — it isn’t yet a fully mature, drop-in replacement at commercial scale, though research continues to advance.

Among current mainstream technologies, heterojunction (HJT) cells have shown the fastest year-on-year reduction in silver use per cell, though back-contact (BC) technology remains the highest silver-consuming mainstream format.

Silver paste has been reported to represent up to 30% of total cell production cost during periods of high silver pricing — a substantial share for a component that makes up a small fraction of the cell’s physical material by weight.

Per-cell and per-watt silver intensity is falling due to thrifting efforts, but total industry silver demand in absolute terms remains historically very high because overall global solar deployment volumes continue to grow.

Silver price volatility is likely to remain a factor in cell pricing for the foreseeable future, given the ongoing global silver supply deficit — though the pace of thrifting and adoption of silver-coated copper alternatives will influence how much of that volatility passes through to buyers.

How to Audit a Solar Cell Manufacturer Before Signing a Supply Contract

How to Audit a Solar Cell Manufacturer Before Signing a Supply Contract

A supplier’s brochure will always show you their best batch. A factory audit shows you their average one — and in a multi-year supply contract, average is what you’re actually buying. With India’s cell supply market tightening under ALMM List-II (see our breakdown of the current supply crunch), procurement teams are under real pressure to lock in suppliers quickly. That pressure is exactly when a structured technical audit matters most — rushed sourcing decisions are how weak suppliers get long-term contracts.

Quick Answer

Auditing a solar cell manufacturer before signing a supply contract should cover three layers: regulatory compliance (ALMM List-II status, certifications), manufacturing process control (EL testing, binning discipline, PID/LID performance data), and commercial capacity (production capacity versus committed order book, raw material supply chain, and financial stability). A thorough audit combines document review, factory visit, and independent third-party verification rather than relying solely on supplier-provided data.

The 15-Point Technical Audit Checklist

Regulatory & Compliance

  1. ALMM List-II status, verified independently. Don’t accept a supplier’s self-declared listing — cross-check the manufacturer name and specific cell model directly against the current MNRE ALMM List-II document, and confirm the revision date. Our detailed guide on ALMM List-II compliance requirements covers exactly what to verify and how.
  2. Certification currency, not just existence. IEC 61215 and IEC 61730 certifications expire and get revised — check the certificate’s issue date and scope, and confirm it applies to the specific cell model and production line you’ll be sourcing from, not just the company generally.
  3. Domestic value addition documentation. For DCR and ALMM-linked projects, confirm the supplier can provide documentation tracing raw material sourcing sufficient to satisfy domestic content requirements on your specific project type.

Manufacturing Process Control

  1. EL testing integration into the production line. Ask whether EL scanning happens as an inline, 100%-of-output quality gate or a sample-based spot check — these represent very different quality assurance postures. See our detailed explainer on EL testing, binning, PID and LID for what good practice looks like here.
  2. Binning distribution data. Request actual binning class distribution reports from recent production batches — a tight distribution around the rated efficiency class indicates strong process control; a wide spread is a red flag.
  3. PID test results per IEC 62804. Request third-party PID resistance test data, not just a manufacturer’s internal claim — this is one of the more commonly overstated specifications in supplier marketing material.
  4. LID/LeTID performance data. Ask specifically what wafer doping approach is used (boron vs. gallium-doped) and what LID mitigation processes are applied, along with supporting test data.
  5. Batch traceability system. Confirm the manufacturer can trace a specific delivered cell batch back to its production date, line, and raw material lot — this matters significantly if a quality issue surfaces post-installation and you need to determine whether it’s isolated or systemic.

Capacity & Commercial Risk

  1. Nameplate capacity vs. actual committed order book. A manufacturer’s stated GW capacity is meaningless if it’s already fully booked by other buyers — ask directly what uncommitted capacity exists for your delivery window.
  2. Raw material supply chain resilience. Given India’s current import dependence on wafers and cell inputs, ask how the manufacturer sources wafers and what contingency exists if their own upstream supply is disrupted.
  3. Production ramp track record. Ask for historical evidence of the manufacturer hitting stated capacity ramp timelines on past expansions — announced capacity and delivered capacity are frequently different numbers in this industry.
  4. Financial stability check. For long-term or high-volume contracts, request basic financial statements or credit information — a supplier’s inability to weather a raw material price spike (silver being a notable current risk factor) can directly threaten your delivery schedule.

Physical & Operational Verification

  1. Factory visit — production line observation, not just office tour. Where feasible, physically observe the diffusion, PECVD, screen-printing, and testing stages in operation, not just a conference room presentation.
  2. Equipment vintage and maintenance records. Older or poorly maintained production equipment often correlates directly with wider quality variance — ask about equipment age and maintenance/calibration schedules for critical process tools.
  3. Reference checks with existing customers. Speak directly with at least two to three existing customers of comparable order size — ask specifically about on-time delivery performance and post-delivery quality issues, not just general satisfaction.

Putting the Checklist to Work

Audit Category

Priority for New Suppliers

Priority for Renewal/Existing Suppliers

Regulatory compliance (#1–3)

Critical — verify before any commercial discussion

Re-verify annually; ALMM listings change

Manufacturing process (#4–8)

Critical — request before factory visit

Spot-check periodically, especially after any reported quality issue

Capacity & commercial (#9–12)

Critical for contracts over 12 months

Reassess at each renewal, particularly capacity commitments

Physical verification (#13–15)

Strongly recommended for orders above a material threshold

Recommended periodically, not just at initial qualification

A Note on Audit Timing

Given the current supply-constrained environment, there’s real pressure to fast-track supplier qualification. Resist compressing the audit itself — instead, compress the decision timeline by front-loading document requests (points 1–8 above) before scheduling a factory visit, so the visit itself becomes a verification step rather than a discovery step.

Websol Energy System publishes its cell datasheet and quality-process documentation directly for procurement review, and as a manufacturer with over three decades of solar cell production experience in India, maintains documented batch traceability and inline quality control across its M10 Bifacial Mono-PERC cell production. Review specifications on the Websol solar cell page, or reach out directly for supply documentation ahead of a factory audit.

Frequently Asked Questions

How long should a full supplier audit take?

For a first-time, high-volume supplier relationship, a thorough audit — document review, factory visit, and reference checks — typically takes several weeks. Compressing this meaningfully increases the risk of missing capacity or quality issues that only surface under sustained production volume.

Documentation review catches most compliance and process-control gaps, but a physical visit remains the most reliable way to verify equipment condition, actual (versus claimed) production line activity, and general operational discipline — particularly for contracts above a material order size.

Reluctance to provide batch-specific test data (EL scans, binning reports, PID/LID results) rather than generic technology-level specifications is one of the clearest warning signs — credible manufacturers with strong process control are typically willing to share this data.

Yes — ALMM List-II has gone through multiple revisions since its June 2026 implementation, and a supplier’s listing status should be re-confirmed for each significant order, not assumed to be permanent from initial qualification.

Price should be evaluated only after a supplier clears the compliance and process-control checks — a lower-priced cell from a supplier with weak batch consistency or unverified capacity commitments often carries higher total project risk than the price difference alone suggests.

Websol Energy

Privacy Policy

We at Websol Energy System Limited respect the privacy of everyone who visits this website and are committed to maintain the privacy and security of the personal information of all visitors to this website.

Our policy on the collection and use of personal information and other information is outlined below.

In case of visiting this website to read or download information, it must be known that Websol Energy System Limited collects and stores a standard set of internet-related information, such as an Internet Protocol (IP) address, the date and time, the type of browser and operating system used, the pages(s) visited. All information is collected to help Websol Energy System Limited for making this site more useful to its customer(s) and only used for statistical purposes.

Websol Energy System Limited collects and uses information such as name, telephone number, email address, etc. in order to:

  • 1. Respond to queries and requests submitted by you
  • 2. Process bids etc.

Except as set out in this privacy policy, Websol Energy System Limited will not disclose any personally identifiable information without permission, unless Websol Energy System Limited is legally entitled or required to do so or if Websol Energy System Limited believes that it is necessary to protect and/or defend it’s rights, property or personal safety etc.

Change of Privacy Policy

Websol Energy System Limited reserves the full rights to change/alter/amend/modify the contents of the privacy policy from time to time without any prior notice or intimation.

Terms and Conditions

VISITORS TO THIS WEB SITE ARE BOUND BY THE FOLLOWING TERMS AND CONDITIONS (“TERMS”). SO, PLEASE READ THE TERMS CAREFULLY BEFORE CONTINUING TO USE THIS SITE. IF YOU DO NOT AGREE WITH ANY OF THESE TERMS, PLEASE DO NOT USE THIS SITE.

The use of this website is subject to the following terms of use:

  • The content of the pages of this website is for your general information and use only. It is subject to change without notice.
  • This website uses cookies to monitor browsing preferences. If you do allow cookies to be used, personal information may be stored by us for use by third parties.
  • Neither Websol Energy System Limited nor any third parties provide any warranty or guarantee as to the accuracy, timeliness, performance, completeness or suitability of the information and materials found or offered on this website for any particular purpose. You acknowledge that such information and materials may contain inaccuracies or errors and we expressly exclude liability for any such inaccuracies or errors to the fullest extent permitted by law.
  • Your use of any information or materials on this website is entirely at your own risk, for which Websol Energy System Limited shall not be liable. It shall be your own responsibility to ensure that any products, services or information available through this website meet your specific requirements.
  • This website contains material which is owned by or licensed to us. This material includes, but is not limited to, the design, layout, look, appearance and graphics. Reproduction is prohibited other than in accordance with the copyright notice, which forms part of these terms and conditions.
  • The  trade mark “” and all products and logos denoted with trade mark are trademarks of Websol Energy System Limited. This trade mark may not be used in connection with any product or service that is not a Websol Energy System’s product, functions or service.
  • Unauthorized use of this website may give rise to a claim for damages and/or be a criminal offence.
  • From time to time this website may also include links to other websites. These links are provided for your convenience to provide further information. They do not signify that Websol Energy System Limited endorse the website(s).
  •
  • Applicable Law and Jurisdiction of this WEBSITE are governed by and to be interpreted in accordance with laws of India, without regard to the choice or conflicts of law provisions of any jurisdiction. The user/site visitor agrees that in the event of any dispute arising in relation to this Disclaimer or any dispute arising in relation to the web site whether in contract or tort or otherwise, to submit to the jurisdiction of the courts located at Kolkata (W.B.) only for the resolution of all such disputes.

Legal Disclaimer​

Copyright Notice

Websol Energy System Limited retains copyright on all the text, contents, graphics and trademarks displayed on this site. All the text, graphics and trademarks displayed on this site are owned by Websol Energy System Limited.

General Information Disclaimer

The information on this site has been included in good faith and is for general purpose only and should not be relied upon for any specific purpose. The user shall not distribute text or graphics to others without the express written consent of Websol Energy System Limited. The user shall also not, without Websol Energy System Limited’s  prior permission, copy and distribute this information on any other server, or modify or reuse text or graphics on this or any another system.

Accuracy of Information

Although Websol Energy System Limited tries to ensure that all information and recommendations, whether in relation to the products, services, offerings or otherwise (hereinafter “information”), provided as part of this website is correct at the time of inclusion on the web site, Websol Energy System Limited does not guarantee the accuracy of the Information. Websol Energy System Limited makes no representations or warranties as to the completeness or accuracy of Information. Certain links in this site connect to other Web Sites maintained by third parties over whom Websol Energy System Limited has no control. Websol Energy System Limited makes no representations as to the accuracy or any other aspect of information contained in such other Web Sites.

Third-Party Links

Certain links in this site connect to other websites maintained by third parties over whom Websol Energy System Limited has no control. Websol Energy System Limited makes no representations as to the accuracy or any other aspect of information contained in such other websites.

Warranty Disclaimer

Websol Energy System Limited hereby disclaims all warranties and conditions with regard to this information, including all implied warranties and conditions of merchantability, fitness for any particular purpose, title and non-infringement.

Limitation of Liability

In no event will Websol Energy System Limited, agents or employees thereof be liable for any decision made by the user and/or site visitor for any inference or action taken in reliance on the information provided in this site or for any consequential, special or similar damages.

Applicable Law and Jurisdiction

Applicable Law and Jurisdiction of this Disclaimer are governed by and to be interpreted in accordance with laws of India, without regard to the choice or conflicts of law provisions of any jurisdiction. The user/site visitor agrees that in the event of any dispute arising in relation to this Disclaimer or any dispute arising in relation to the website whether in contract or tort or otherwise, to submit to the jurisdiction of the courts located at Kolkata (West Bengal) (India) only for the resolution of all such disputes.

Forward-Looking Statements

Except for the historical information herein, statements in this website, which include words or phrases such as “will”, “aim”, “will likely result”, “would”, “believe”, “may”, “expect”, “will continue”, “anticipate”, “estimate”, “intend”, “plan”, “contemplate”, “seek to“, “future”, “objective”, “goal”, “likely”, “project”, “should”, “potential”, “will pursue”, and similar expressions or variations of such expressions may constitute “forward-looking statements”. These forward-looking statements involve a number of risks, uncertainties and other factors that could cause actual results to differ materially from those suggested by the forward-looking statements. These risks and uncertainties include, but are not limited to our liability to successfully implement our strategy, our growth and expansion plans, obtain regulatory approvals, our provisioning policies, technological changes, investment and business income, cash flow projections, our exposure to the market risks as well as other risks. The company does not undertake any obligation to update forward-looking statements to reflect events or circumstances after the date thereof.
